Bearaco

A better structure must change how the work gets done.

We help CEOs, COOs and functional leaders redesign responsibilities, capabilities and interfaces when the organisation no longer fits the business.

Illustrative operations leader and consultant observing an industrial workflow
Designing around the work
Illustrative team mapping responsibilities and workstreams with cards
Clarifying roles and responsibilities

When needed

A divestment leaves the old support structure behind

Group and business-unit responsibilities still serve a business that no longer exists.

An acquisition closes but duplicate teams remain

Integration has not resolved ownership, service levels or overlapping capabilities.

A reorganisation changes reporting lines but not decisions

Approvals still cross the same interfaces and escalation remains routine.

A footprint decision reaches implementation

Work must move between sites, shared services or suppliers without losing critical capability.

Our approach

Four steps take the work from framing the question to executing the agreed changes, with service-specific activities and a decision gate at the end of each step. We agree the scope, evidence requirements and owners for each phase before work starts.

Duration: 1–2 weeks

Step 1: Frame

Map roles, decisions, activities, service levels and interfaces alongside the people and cost baseline.

Gate 1

HR and finance reconcile roles and costs to their source systems; disputed ownership is recorded.

Duration: 8–12 weeks

Step 2: Diagnose

Compare central, local, shared and external delivery models against service and capability needs.

Gate 2

Sponsor selects a model only after decision rights, service impacts and transition risks are reviewed.

Duration: 4–6 weeks

Step 3: Validate

Translate the design into role mapping, interfaces, service agreements and implementation waves.

Gate 3

Line owners accept the transition plan; people, service and regulatory dependencies have named owners before launch.

Duration: 6–18 months

Step 4: Execute

Implement the new roles, interfaces and service model in waves, working alongside line leaders to build capability and maintain service continuity.

Gate 4

Each wave requires readiness sign-off; line owners accept service performance, decision rights and the handover.

Deliverables

Step 1: Frame

Design mandate and service requirements

Agreed organisational scope, design principles, service requirements and decision owners. Set the measures for cost, capacity, accountability and service continuity before evaluating structures.

Step 2: Diagnose

Activity-cost baseline and operating-model options

A reconciled map of roles, activities, decisions and costs, with central, local and shared-service options. Quantify recurring cost implications, capacity changes and transition costs alongside service risks.

Step 3: Validate

Target operating model and transition business case

Validated decision rights, role maps and service agreements, with implementation waves and readiness gates. Confirm net recurring savings, one-off costs and payback with finance and line owners.

Step 4: Execute

Transition control book and benefits tracker

An owned migration plan, readiness checks and service-performance dashboard. Track actual cost, capacity and service levels against the baseline, distinguishing released capacity from realised savings.

Each phase leaves a working asset with an owner, source references and an update process. Economic estimates distinguish potential value from approved commitments and realised results.

Illustrative example

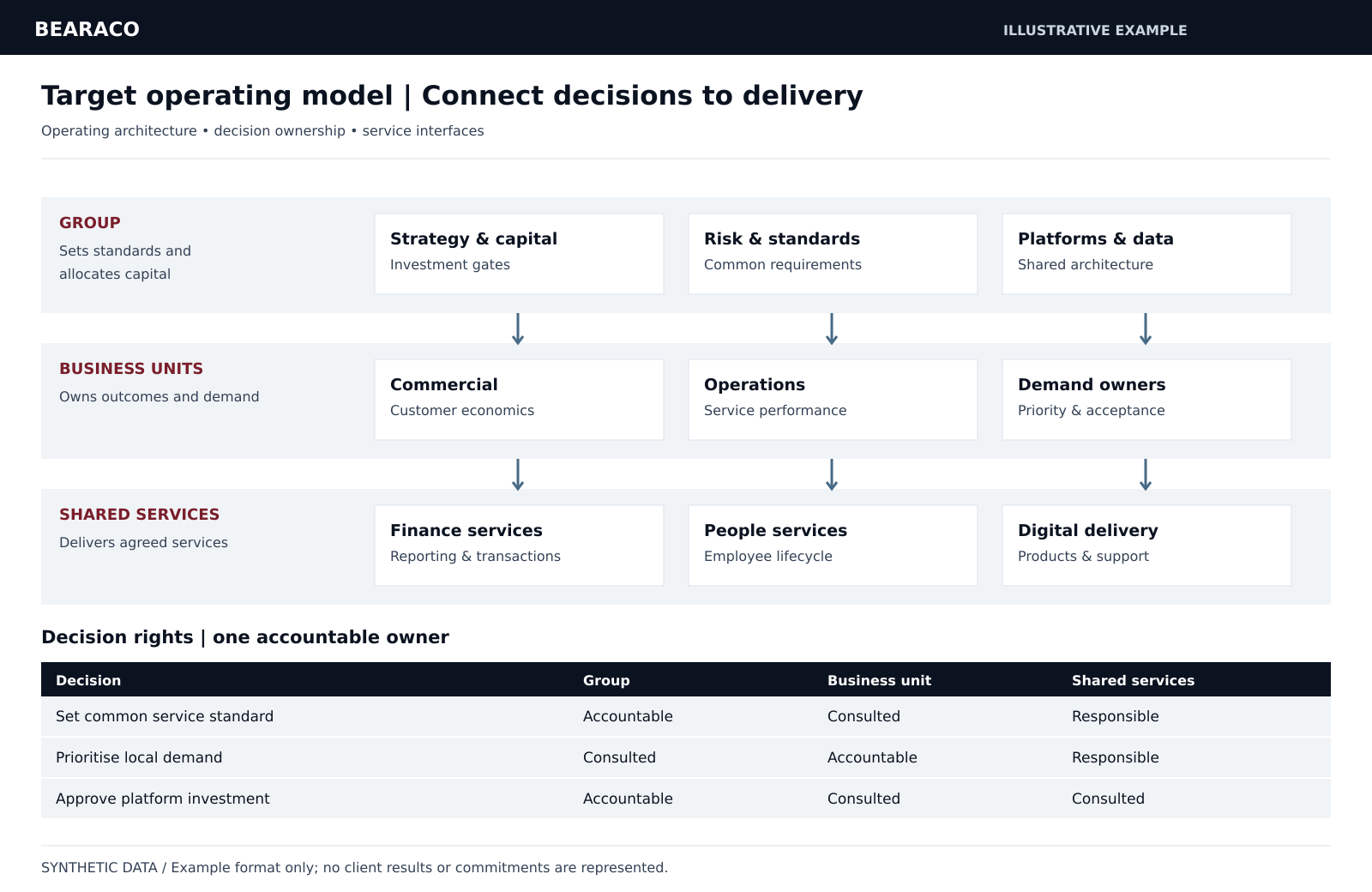

Operating architecture and decision rights

Map responsibilities across the group, business units and shared services, with an accountable owner for each key decision.

Sample data, not a client deliverable. The format is tailored to the engagement.

View full-size example ↗
Illustrative operating architecture and decision rights with sample data. Map responsibilities across the group, business units and shared services, with an accountable owner for each key decision.

Team & Duration

You get direct access to partner judgement, a team working inside your business and a shared focus on economic impact. We work through the difficult questions with you and stay close as decisions become action.

A senior team, working with you

Partner judgement at the problem-solving table
1 accountable partner. Works directly on your hardest questions: shaping hypotheses, examining the evidence and developing recommendations with your team. Regular joint working sessions and partner-led decision gates bring senior judgement into the work throughout the engagement.
Day-to-day momentum, inside your business
1 Engagement manager. Works side by side with your people, including from your offices. Connects the analysis to operational reality, resolves blockers and turns decisions into owned actions.
Analytical depth focused on value
2–3 consultants. Combine rigorous analysis with our proprietary AI harness to test opportunities, quantify the economics and build practical working assets with your team. You gain a stronger fact base and tools your people can keep using.
Expertise that makes recommendations practical
1 expert. Brings relevant industry or service experience to test assumptions, challenge feasibility and identify the constraints that matter before you commit resources.

Duration & Fees

A clear path from question to impact
Duration of each step: Frame: 1–2 weeks. Diagnose: 8–12 weeks. Validate: 4–6 weeks. Execute: 6–18 months. We agree the scope, owners and decision gates before work starts.
Continuity from insight to execution
The partner and engagement manager are planned to stay from Frame through Execute, carrying the context and accountability into implementation. Any change to the core team is discussed and agreed with you.
Fee certainty upfront. Alignment on results.
Steps 1–3 (Frame, Diagnose and Validate) are fixed-fee, with scope and deliverables agreed for each step. Execute can include performance-based fees linked to agreed outcomes, baselines and measurement rules.
You control the next commitment
At each decision gate, choose to proceed, adjust the scope or take the working assets forward with your own team. Each further commitment follows an explicit decision, with ownership and handover built into the work.

Cases

Selected anonymised engagements. Many span several services; each case shows the relevant areas of work alongside its outcome.

Explore all Operating Model cases →
Baselines, timeframes and evidence

European construction group

Starting position
Duplicated construction support functions; up to nine organisational layers and average span of control of 4.2.
Timeframe
Design and transition engagement; elapsed duration is not recorded in the case.
Recorded facts and outcomes
Layers reduced from up to nine to six, and average span increased from 4.2 to approximately 6.5; approximately 450 positions were consolidated into shared functions.
Judgement, targets and limits
The case supports an organisation-design outcome. It does not provide a time-windowed savings result, so none is claimed.

Telecom operator

Starting position
Telecom operator with approximately 20,000 employees and support-function spans averaging below four.
Timeframe
Three implementation phases; elapsed calendar duration is not recorded.
Recorded facts and outcomes
Approximately 2,500 positions were removed across the three phases—about 12% of the workforce—with network and frontline capabilities ring-fenced.
Judgement, targets and limits
The case records headcount change and capability protection, not a quantified service-performance or financial outcome.

Figures are approximate. EUR conversions are documented in the full cases. These engagements illustrate experience, not forecasts for a new assignment.

Other services

The main task is to turn an agreed cost target into P&L savings

Cost Out →

When to do it yourselves

If the issue is a single unclear interface and the accountable leaders can agree ownership directly, resolve it locally rather than launching an organisation-wide redesign.

Talk it through with a partner.

Bring one decision or handoff that repeatedly gets stuck. In 30 minutes, we can map the interface and assess whether the problem needs a local fix or a broader operating-model change.

Bearaco partners
